Order Acceptance
After signing your order with your 2 Circles representative, your order will be handed over to our provisioning specialists, Order Hub, for verification and quality control. Order Hub will then begin liaising with our partners and suppliers to help ensure a smooth delivery of service.
Survey & Planning
Once the order has passed quality control your order will be assigned a Site Survey Engineer who will survey the order location comprehensively to draw detailed construction and installation plans. It is important to have a representative present during this survey to ensure the Surveyor is aware of where the line needs to enter your premises (I.e. Your comms or IT room). Your Site Survey Engineer will visit your premise within the time slot advised by Order Hub (AM = 8am-1pm or PM=1pm-6pm).
When multiple delivery routes are identified the Survey and planning stage can be delayed whilst the network planning team consider the best course of action for delivery of service.
Wayleave
When work is required on privately owned land, BT Openreach require written consent (Wayleave) from the land owner that grants access to install and maintain or repair network equipment. As this stage is reliant on third party participation, delays can occasionally arise.
Excess Construction Charges (ECC’s)
Depending on the network planners chosen delivery route, some orders incur Excess Construction Charges (ECC’s). Typically, this is when non-standard work or materials are required to achieve a fibre presence at the premises.
We understand that these charges may require some additional consideration. If ECC’s are applicable, we will place your order on hold for up to 25 days, so you have plenty to decide whether to proceed with your order. After this 25-day period, if no decision has been reached the order will be automatically cancelled but can be requoted and replaced thereafter. After you have been quoted ECCs, any additional network construction charges thereafter will not be chargeable to you.
External Works
Some installations involve external works such as road works, installing new ducting, repairing blocked and damaged ducting, splicing and blowing fibre and working with non-standard joint boxes. Although external works are not often required, in the rare instance they are required they can cause delays of up to 8 weeks depending on the scale of the works.
Install, fit and provisional testing
An Engineer will be tasked with executing the planning teams’ instructions and will visit your site to complete installation of the internal cabling the Network Terminating Equipment (socket). Again, it is important at this stage to have a representative present to ensure the Engineer installs the socket in the same location that had been requested during the Survey and Planning Stage.
Once the NTE has been installed the engineer will conduct provisional testing on the line to ensure the internal cabling is working and operational.
Testing
The network will then perform further testing back to the core network to ensure the circuit connection and speeds are as expected, this can take up to 10 working days.
Wires Only
A Wires only service means that we do not provide you with any equipment beyond that provided by the network. Once the Testing phase has been completed, your Order Hub representative will contact you with an IP handover, this will provide you with the basic IP and configuration information you will need to set-up your router.
Managed Service
If you have a SCG Together Managed Service, our IT Solutions team will be in contact arrange router configuration. This will either involve delivery of a simple ‘plug and play’ router, remote router configuration or, for more complex solutions, on site configuration. Our specialist IT Solutions teams will then conduct further remote testing to ensure the service is functional and usable.
Circuit Live
Upon completion of the final testing, you will be able to connect your network and devices and begin using your 2 Circles Leased Line.

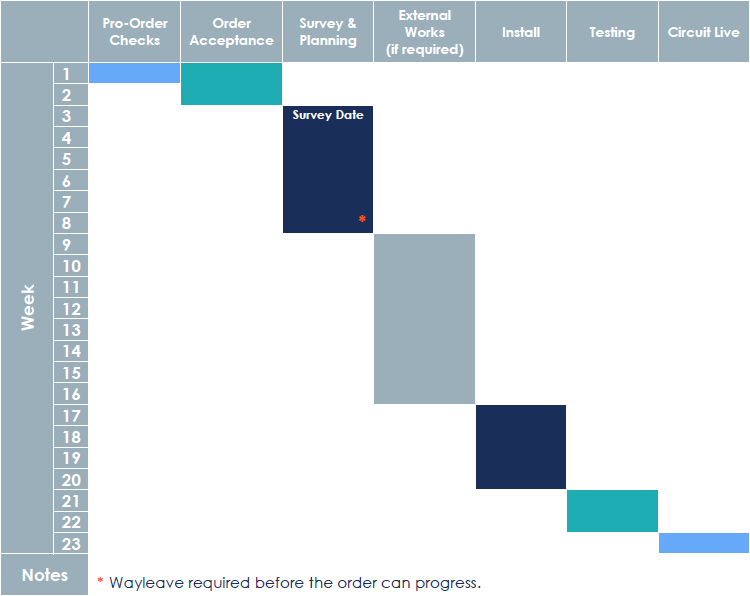

Timescale
Please note that installations of this type require cooperation from third parties and several external parties including Openreach, so where timescales are given, these are purely indicative and should be considered as guidelines instead of guarantees.
